Free template
Subcontractor Invoice Template (US, UK CIS & AU Payment Claims)
A free subcontractor invoice template built for the way trade subs bill a general contractor's accounts office. It keeps the subcontract or PO number, current progress claim, retention and change work visible. If you bill clients directly, the independent contractor invoice template fits that workflow. Download a blank PDF, Word or Excel file below, or open the generator.

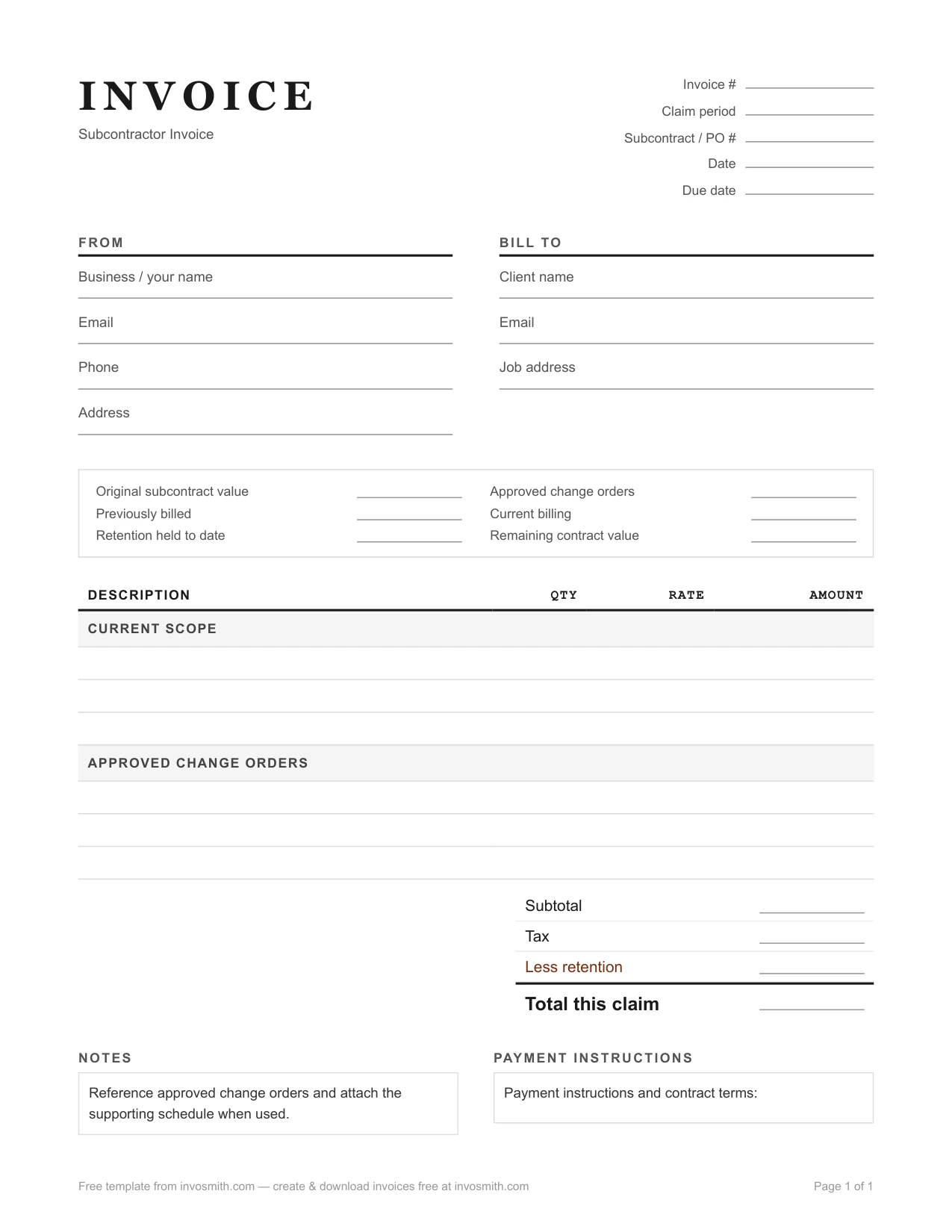

Download the subcontractor invoice template
Every download is free - no email, no sign-up, no watermark.
What a subcontractor invoice needs that a normal one doesn't
A GC's accounts team matches each claim against a subcontract, schedule of values and prior billing. Give them the same references and labels they already use:
- Subcontract or PO number: place it near the invoice number.
- Project and phase: job name, site address and the scope billed this period.
- Current work: completed quantity, percentage or scope line at the subcontract price.
- Contract summary: contract value, previously billed, current billing, retention held and remaining balance.
- Retention held: show it as a separate negative line and keep a held-to-date total.
- Change orders: give each extra its approval or change-order reference.
- Tax (if applicable): manually entered amount.
- Amount due, terms and payment instructions.
Example: a progress claim with retention
This fictional example separates current work, an approved change order and retention. The values illustrate layout rather than a standard rate.
The summary lets the accounts team match the current claim with the contract ledger in one pass.
| Description | Example amount |
|---|---|
| Framing — Level 2 complete (subcontract S-1142) | 14,000.00 |
| CO-03 — additional blocking, approved 12 June | 850.00 |
| Work this claim | 14,850.00 |
| Retention held this claim | −1,485.00 |
| Tax (if applicable) | — |
| Amount due this claim | 13,365.00 |
| _Example contract summary: original value 48,000 · approved COs 850 · adjusted value 48,850 · previously billed 12,000 · current billing 14,850 · retention held to date 2,685 · remaining 22,000_ |
Billing situations subcontractors hit
Progress billing. Reuse the subcontract number and schedule-of-values labels each period. This progress-billing walkthrough shows how to reconcile prior billing, current work and remaining value.
Retention release. When retention becomes payable, use a separate line naming the subcontract and accumulated amount. The US section below records California timing for a direct contractor that receives a retention payment.
Change orders. Put approved extras on separate lines with their approval reference; keep pending work out of the amount due.
GC versus owner. Bill the party named in the subcontract. A construction invoice template shows the general-contractor view of the same billing chain.
Common subcontractor invoice mistakes
- No subcontract number. The accounts team loses the match to its own record.
- Different scope labels. Mirror the GC's schedule-of-values wording.
- Hidden retention. Keep current and cumulative retention visible.
- Extras without references. Name the change order or written approval.
- Missing prior-billing totals. Reconcile previously billed, current billing and remaining value on every progress claim.
UK: CIS subcontractor invoices
Under HMRC CIS 340, the contractor determines the subcontractor’s CIS status with HMRC and applies any required deduction to the part of the payment that does not represent the subcontractor’s material costs. Separate labour and materials on the invoice and leave the deduction amount for the user to enter.
Include the UTR to help the contractor identify and check the subcontractor; CIS 340 does not make the UTR a universal invoice field. Keep the CIS status and deduction amount as entered records rather than calculating a rate in this template.
| CIS invoice line | Amount |
|---|---|
| Labour | |
| Materials incurred by subcontractor | |
| CIS deduction entered by user | |
| Amount due |
Australia: progress claims and payment claims
A progress claim records the amount claimed for construction work completed or related goods and services supplied under the contract. In New South Wales, Security of Payment Act 1999 s 13(2) and (4) requires a payment claim to identify the work or related goods and services, state the claimed amount, state that the claim is made under the Act, and be served within the contract period or within 12 months after the relevant work or supply was last carried out, whichever is later.
In Queensland, Building Industry Fairness Act 2017 s 68 defines a payment claim as a written document that identifies the work or related goods and services, states the claimed amount, requests payment, and includes prescribed information. A document bearing the word “invoice” satisfies the request-for-payment element.
A payment claim is the statutory claim document described by the applicable Act; an invoice is the commercial bill and can also serve as the claim when it contains the required elements.
The ATO TPAR guidance says qualifying building and construction businesses report payments made to contractors and subcontractors. Clear ABN and amount fields support that record. The ATO no-ABN withholding guidance says a payer may need to withhold at the highest rate when a supplier does not quote an ABN.
US: deposits, retainage and prompt pay
Show a deposit as a negative line with the receipt reference. For retainage, show current retention, held-to-date and the release amount separately.
California Business and Professions Code §7108.5 requires a prime contractor or subcontractor to pass each subcontractor’s allowed share of a progress payment within seven days after receipt unless otherwise agreed in writing.
When a California direct contractor has withheld retention, Civil Code §8814 requires it to pay each affected subcontractor’s share within 10 days after receiving all or part of a retention payment. A retention payment specifically designated for one subcontractor goes to that subcontractor when consistent with the subcontract.
Texas Property Code §28.002 gives an owner 35 days after receiving an allowed written payment request to pay the contractor and gives contractors and subcontractors seven days after receipt to pass attributable payment downstream. Section 28.004 sets statutory late-payment interest at 1.5% per month on an unpaid amount required by that chapter; that figure is an interest rule, not tax.
For payments made after December 31, 2025, the statutory information-reporting threshold for affected nonemployee compensation increased to $2,000. Internal Revenue Bulletin 2026-19 explains the change. Form 1099-NEC is the payer’s information return, not the subcontractor’s invoice. The independent contractor invoice page covers direct-client billing.
Frequently asked questions
What's retention (retainage) and how do I show it?
It is an amount held under the subcontract. Show current retention as a negative line, maintain a held-to-date figure, and identify a later release as its own line.
What is a progress claim in construction?
It is a claim for payment for construction work completed or related goods and services supplied under the contract. Identify the period, project, scope, claimed amount and prior billing.
Payment claim vs invoice — what's the difference?
A payment claim invokes the applicable security-of-payment process and must contain that law’s required elements. An invoice is the commercial bill; in Queensland, an invoice can satisfy the request-for-payment element when the other s 68 elements are present.
How do I show CIS deductions on an invoice?
Separate labour and materials, include the UTR to help identification, and leave a clearly labelled CIS deduction line for the user-entered amount. The contractor determines status and deduction with HMRC.
How do I invoice as a subcontractor?
Use the subcontract or PO number, project and phase, current scope lines, prior billing, retention and approved change-order references. Keep the amount due tied to the contract summary.
Do I invoice the general contractor or the property owner?
Invoice the party named in the subcontract, commonly the general contractor, using the references its accounts office uses.
How does progress billing work on an invoice?
Bill the current completed portion by scope line, then reconcile previously billed, current billing, retention held and remaining contract value.
Can I charge interest on late progress payments?
Follow the late-payment and interest terms in the subcontract first. Texas is one example: Property Code §28.004 applies statutory interest of 1.5% per month to overdue amounts required by Chapter 28. Show any applicable interest as a separately referenced line, not as tax.
Can I create the invoice online?
Use the free invoice generator for the billing lines and PDF download. See what Invosmith Pro includes.
